Services · Construction noise and vibration

Construction Noise Monitoring and BS 5228 Assessments

BS 5228 construction noise and vibration assessments, Section 61 applications and on-site noise monitoring for developers and contractors.

We predict noise and vibration from your programme before work starts, agree limits with the council, and monitor during the works so problems are spotted early and your site keeps moving, following BS 5228-1 and BS 5228-2.

MIOA acoustic consultant · Class 1 instrumentation · Fixed-fee quotes · Site visits typically within 3–5 working days

acoustic plant noise assessments for planning and Construction noise impact assessments and acoustic report for planning and section 61 consent.

At a glance

Standards

BS 5228-1 and BS 5228-2

Legislation

Control of Pollution Act 1974

Deliverable

Assessment, S61 support, monitoring

Used for

Planning, CEMPs, Section 61

65 dB

Weekday daytime threshold, Category A, LAeq

55 dB

Evenings and weekends threshold, Category A

45 dB

Night-time threshold, Category A

1.0 mm/s

Vibration likely to cause complaint, PPV

Category A thresholds from BS 5228-1:2009+A1:2014 Annex E (ABC method), which rise for noisier sites. Vibration guidance from BS 5228-2:2009+A1:2014 Table B.1.

When you need one

When Do You Need a Construction Noise Assessment?

Construction noise is temporary, but councils still expect it to be planned and controlled, especially for long programmes, piling, demolition or out-of-hours work near homes.

Planning Conditions and CEMPs

Construction environmental management plans and conditions that ask for noise and vibration to be assessed and controlled.

Section 61 Prior Consent

Applications under the Control of Pollution Act 1974, agreeing methods, hours and limits with the council before work starts.

Monitoring During the Works

On-site noise monitoring to show compliance with agreed limits and respond quickly if complaints arise.

Factory Building 1 Streamline Icon: https://streamlinehq.com

Piling, Demolition and Out-of-Hours Work

High-impact activities, night working or long programmes close to homes, schools or offices.

Already received a planning condition or an Environmental Health request for a noise assessment?

Send us the details

What's included

What a BS 5228 Assessment Covers

BS 5228 sets out how to predict and control construction noise and vibration. We turn your programme, plant list and methods into predicted levels at each neighbour, then set practical limits and controls.

Agreeing limits before work starts gives the council confidence and protects your programme from stop notices.

a person is writing on a piece of paper agreeing to noise assessment cost in the UK

Fees guide

Noise Assessment Cost UK: 7 Key Price Factors Explained

Baseline noise survey

Measurement of existing ambient noise at the nearest homes, used to set ABC method thresholds.

Output: threshold category for each neighbour

Noise predictions by phase

Predicted levels for demolition, groundworks, piling, frame and fit-out, using BS 5228-1 source data.

Output: noise levels by phase

Vibration assessment

Predicted vibration from piling, compaction and breaking, judged against BS 5228-2 guidance for people and buildings.

Output: PPV predictions

Best practicable means

Practical controls such as quieter methods, screening, plant siting, working hours and respite periods.

Output: mitigation schedule

Section 61 application support

The technical content for a Section 61 application, agreed with Environmental Health before work begins.

Output: S61 noise and vibration content

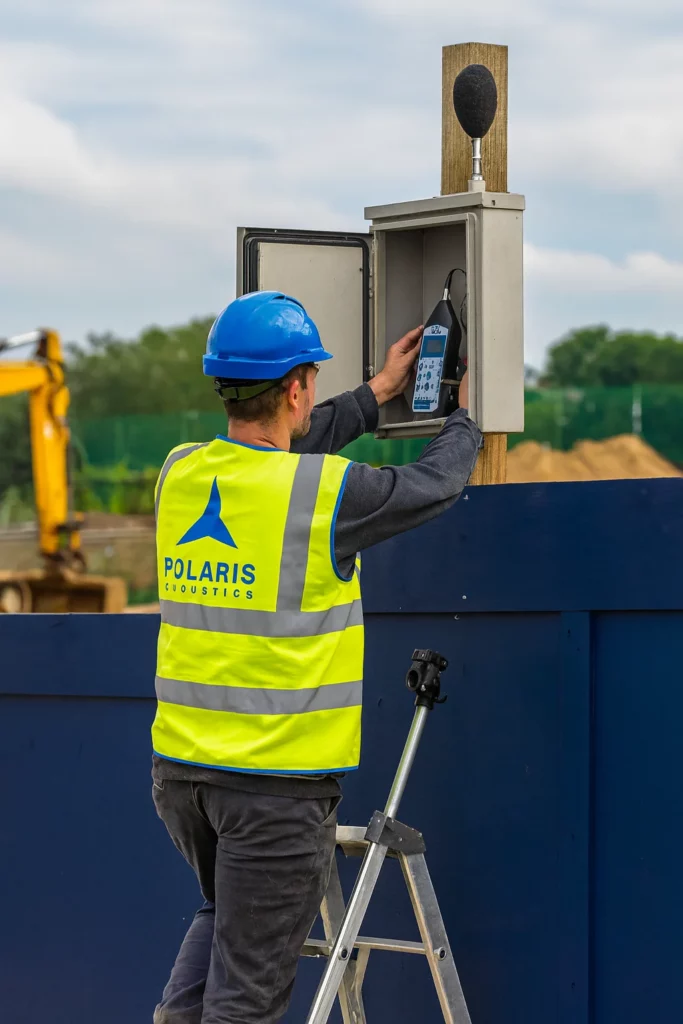

Noise monitoring

Unattended monitoring with Class 1 instrumentation at agreed positions, with regular reporting against the limits.

Output: compliance reports

How it works

From Enquiry to Planning-Ready Report

A clear, fixed-fee process built around your build programme. You always know what is being assessed, what the limits are, and how compliance will be shown.

01

Send Us the Details

Share the site address, drawings and any planning condition or EHO comments. We confirm the right assessment and send a fixed-fee quote.

02

Noise Survey on Site

We measure the existing noise climate with Class 1 instrumentation, including night-time and unattended monitoring where the assessment calls for it.

03

Assessment and Report

Results are assessed against BS 8233, ProPG, BS 4142 or BS 5228 as relevant, with clear, practical mitigation set out for your design team.

04

Planning Support

We respond to questions from planning officers and Environmental Health, and help you discharge noise-related planning conditions.

What we assess

The Construction Activities We Assess

Each assessment uses your actual programme and plant list, so the limits and controls reflect how the site will really be built.

Demolition

Breakers, crushers and demolition plant, including dust and noise controls.

Factory Building 1 Streamline Icon: https://streamlinehq.com

Piling

Driven, CFA and rotary bored piling, including vibration at nearby buildings.

Groundworks

Excavators, dumpers, compaction and muck-away traffic.

Concrete and Frame

Pumps, mixers, cranes and steel or timber frame erection.

Site Traffic and Deliveries

HGV movements, reversing alarms and early-morning deliveries.

Out-of-Hours Works

Night and weekend working, concrete pours and possessions.

Policy and guidance

Assessed Against the Right Legislation and Standards

Assessments follow BS 5228 and the Control of Pollution Act 1974, framed around the council’s planning conditions and any code of construction practice it publishes.

Planning policy

NPPF and PPG Noise

Planning Policy Wales and TAN 11

NPF4 and PAN 1/2011

Local requirements

Construction management plans

Codes of construction practice

Permitted working hours

Planning conditions

Standards and guidance

BS 5228-1:2009+A1:2014

BS 5228-2:2009+A1:2014

Control of Pollution Act 1974

Section 61 consent

Considerate Constructors

Where we work

Construction Noise Assessments Across the UK

We provide BS 5228 assessments, Section 61 support and construction noise monitoring for developers and contractors throughout the UK.

Across England

Planning noise work for councils from Cornwall to Cumbria, run from our Southampton base.

London · South East · South West · East of England · Midlands · North West · North East · Yorkshire

Wales, Scotland, Northern Ireland and Guernsey

Assessments framed around each nation's own planning policy and Environmental Health expectations.

Cardiff · Newport · Swansea · Glasgow · Edinburgh · Dundee · Aberdeen · Belfast · Guernsey

Frequently asked questions

Construction Noise: Your Questions Answered

Straight answers to the questions developers, contractors and site managers ask us most about construction noise and BS 5228.

What is BS 5228?

BS 5228 is the British Standard code of practice for noise and vibration control on construction and open sites. Part 1 covers noise and Part 2 covers vibration. It gives methods for predicting levels, example criteria and guidance on best practicable means of control.

What is the ABC method?

The ABC method in BS 5228-1 Annex E sets threshold levels for construction noise based on the existing ambient noise at each neighbour. For the quietest areas (Category A) the thresholds are 65 dB LAeq on weekday daytimes, 55 dB in the evening and at weekends, and 45 dB at night, rising for Categories B and C.

What is a Section 61 consent?

A Section 61 consent, under the Control of Pollution Act 1974, is an agreement with the council, made before work starts, on the methods, hours and noise controls for a site. It gives the contractor protection from a Section 60 notice as long as the agreed terms are followed.

What is a Section 60 notice?

A Section 60 notice is served by the council to control noise from construction works, usually after complaints. It can restrict working hours, methods or noise levels, and breaching it is an offence.

How much does construction noise monitoring cost?

It depends mainly on how long monitoring runs, how many positions are needed and how often you need reporting. An initial BS 5228 assessment is usually a fixed fee, with monitoring priced per week or month. Our guide to noise assessment costs explains the main price factors.

Do you assess vibration as well as noise?

Yes. We predict vibration from activities such as piling, compaction and breaking, and assess it against BS 5228-2 guidance for both people and buildings. As a guide, 1.0 mm/s PPV is likely to cause complaint in homes, but can be tolerated with prior warning and explanation.

Can construction hours be extended?

Sometimes, if the noise impact is acceptable and the council agrees. A BS 5228 assessment showing predicted levels and controls for the extended hours is usually needed, often as part of a Section 61 application.

What noise controls are typical on site?

Common measures include quieter methods and plant, acoustic screens and hoarding, siting noisy plant away from homes, respite periods, considerate delivery times and good communication with neighbours.

What does a construction noise report include?

The site and programme, the nearest neighbours, baseline noise levels and ABC categories, predicted noise and vibration by phase, comparison with thresholds, best practicable means and, where needed, a monitoring plan and limits.
